News
The Dredge Report | Week of May 2, 2021
Published on: May 11, 2021
Sand Shifter – Aunt Lydia’s Cove, Chatham
Work continued on the staging for Phase 2 of the Aunt Lydia’s Cove project. On Monday & Tuesday, the crew continued to move pipe to the discharge location along the beach just south of Minister’s Point. Dredging started on Wednesday and continued through Saturday. The Pre-Dredge volume to be dredged was 10,000 Cubic Yards that will be used to replenish the heavily eroded beach to the south of Minister’s Point.

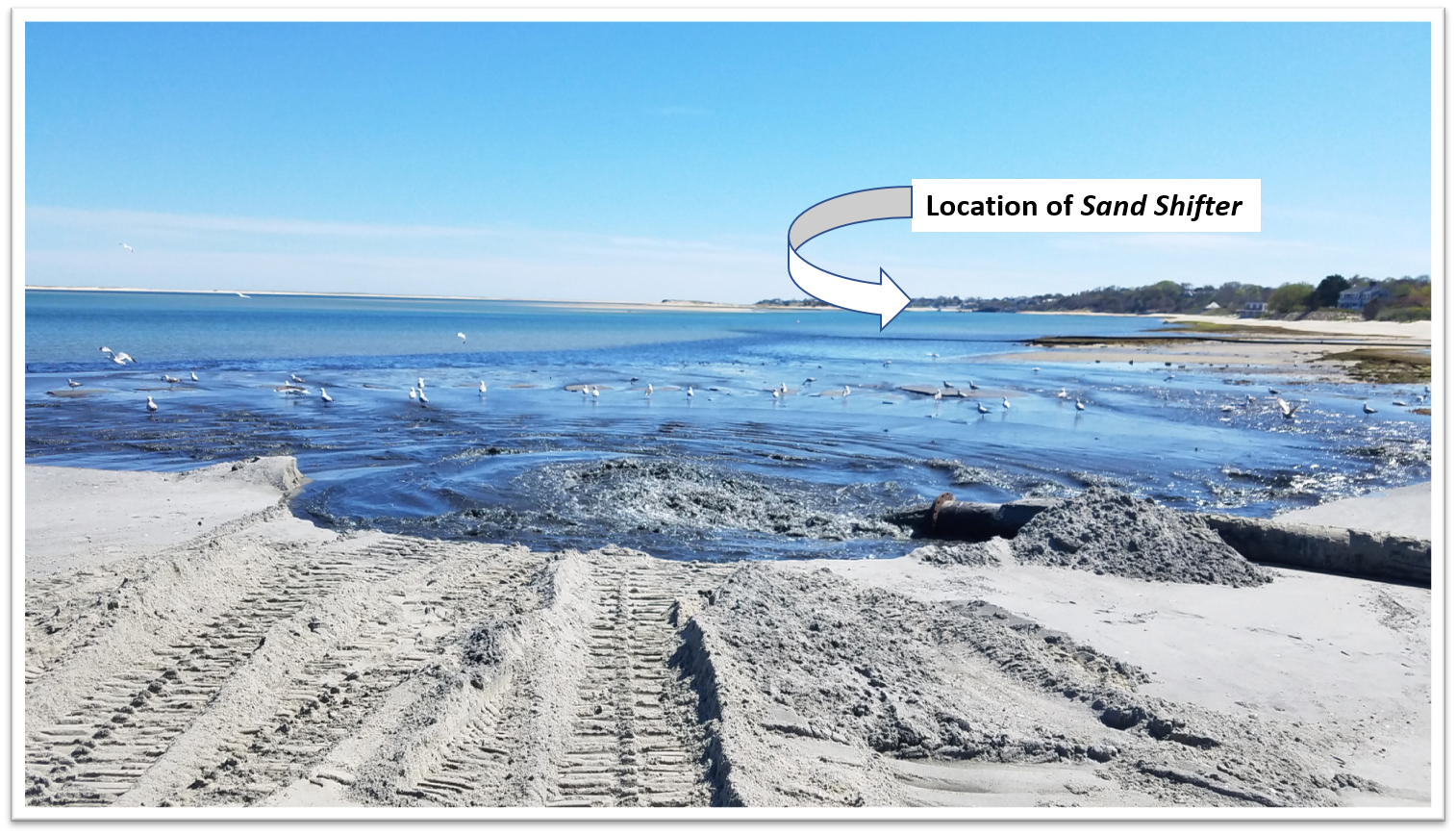

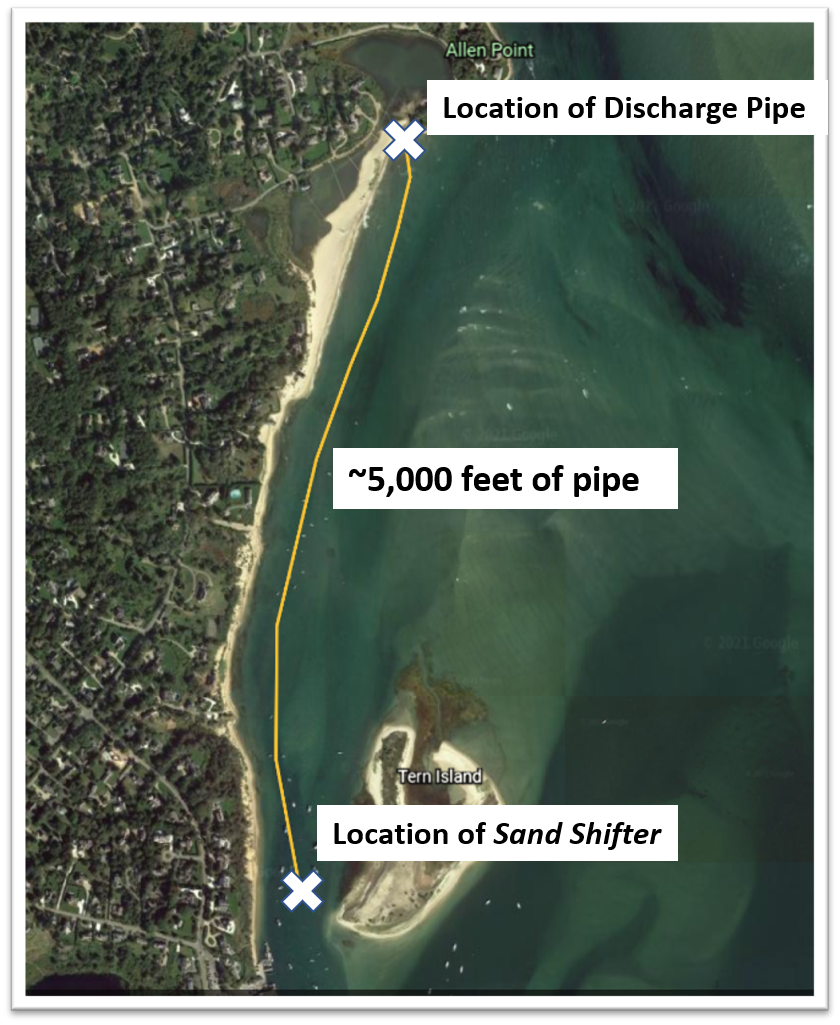

Aerial overview showing the approximate location of the Sand Shifter and pipe to the discharge location at the base of Linnell Lane
View from discharge location looking south to Sand Shifter, approximately 1 mile

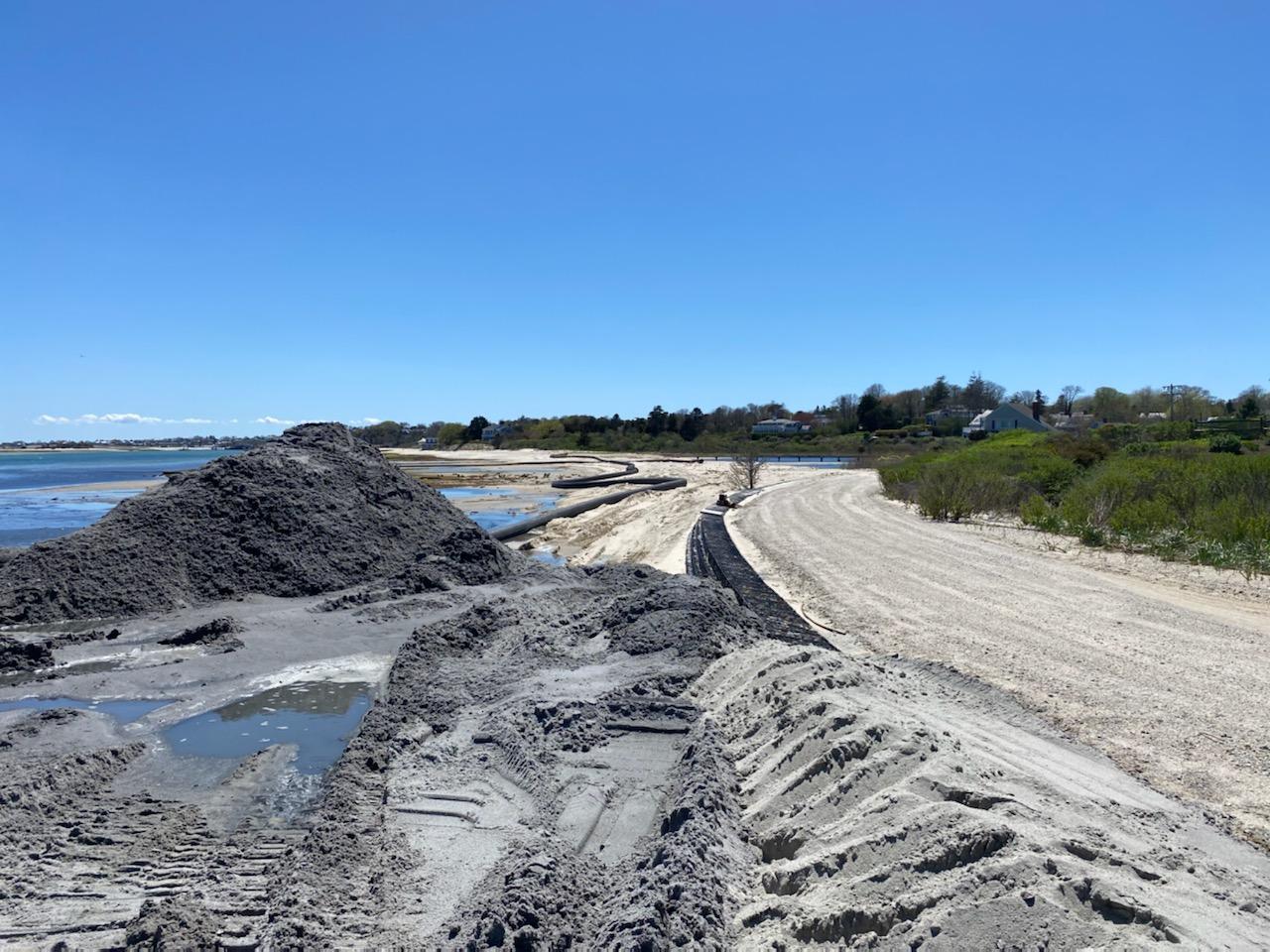

Sand building up after only 2 days of dredging
Dredge material (sand & water) discharging from pipe
Panoramic picture of discharge location (photo taken by Dredge Foreman Tanner Daily)

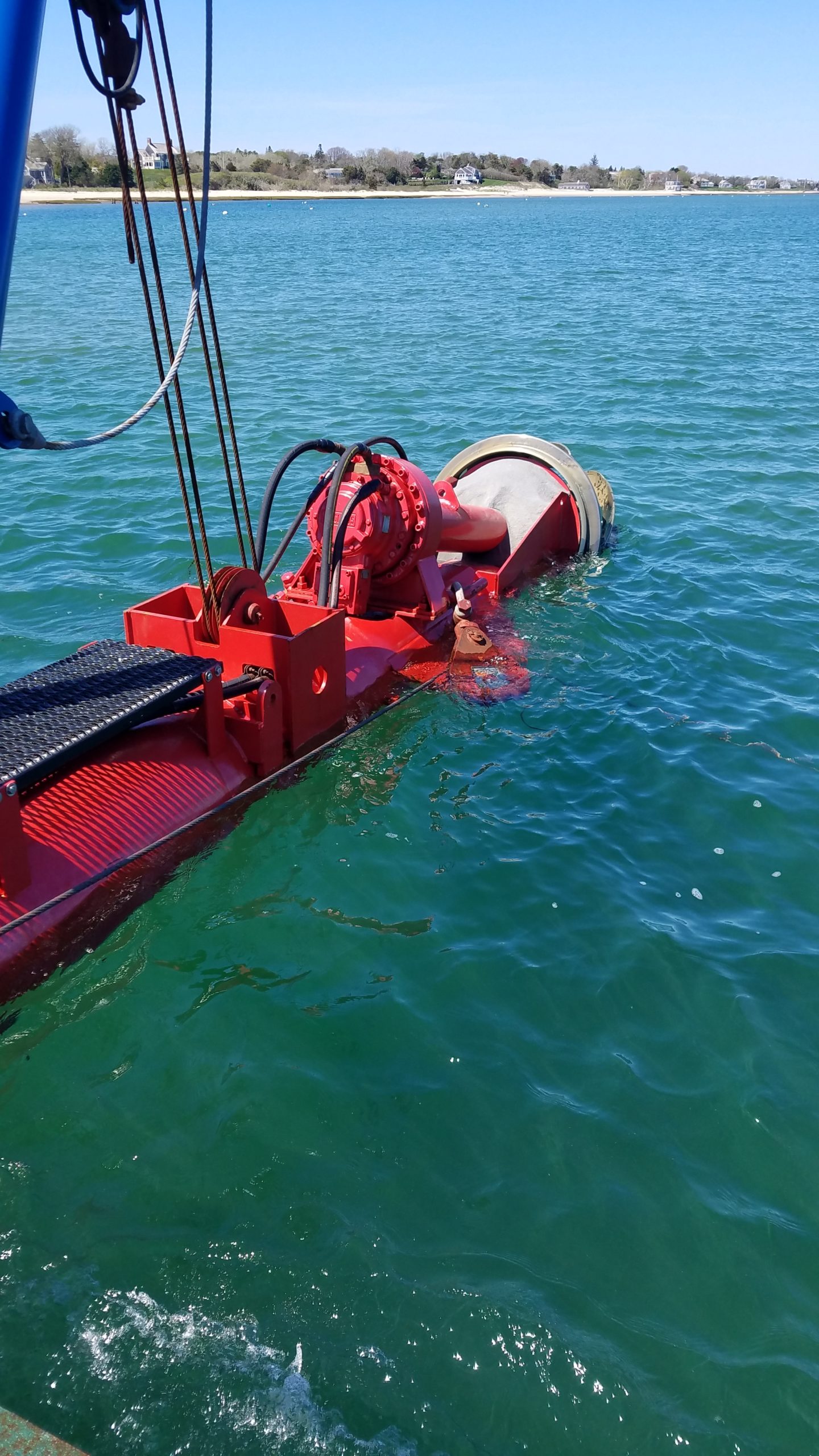

Cutterhead being lowered to start dredging
Two black balls one over the other is the day shape that is displayed warning other vessels that there is an
obstruction on this side (such as pipe lines in this case)
