The Dredge Report | Week of January 24, 2021

Cod Fish II – Sesuit Harbor, Dennis

Sesuit Harbor, Dennis

Dredging took place just two days last week. The weather on Monday still had seas to high keeping the Cod Fish II inside the harbor. On Tuesday the crew was needed to help with the staging for the Stage Harbor project (see below). On Wednesday and Thursday, the Cod Fish II crew resumed dredging and finished the Sesuit Harbor project which was just in time to remove the pipe from the dredge and move her and the J.W. Doane (one of our two Pushboats) inside the harbor before the Nor’easter.

The Cod Fish II will take a short break before starting the next project which right now is scheduled to be Popponesset Channel in Mashpee starting sometime next month.

Sand Shifter – Little Bay, Bourne —-> Stage Harbor, Chatham

Stage Harbor, Chatham

Like a giant jig saw puzzle, there are many parts to this project that are required before the first Cubic Yard of sand is pumped. Each day brings about another task which requires our entire dredge team.

In the dredge industry, the staging of the equipment is called ‘mobilizing’.

As noted above, we also had to finish up the dredging in Sesuit Harbor as we had a January 31st TOY (Time of Year) dredging restriction in place which prohibited dredging beyond this date.

To follow are just a few of these mobilizing tasks:

  • The 6,500 feet of pipe that was used in Bourne for the Little Bay project had to be broken down into three sections. These sections had to be capped, and then floated so they could be towed to Stage Harbor, Chatham.
  • Towing the pipe. Last Monday we hired R.B. Our to tow these sections of pipe to Chatham. It was a simple exercise for them using one of their large coastal tugs. The pipe arrived in Stage Harbor late afternoon and was met by our work skiffs and 35’ Duffy – the Commander.
  • Moving the Sand Shifter to Stage Harbor. Once the pipe was under tow, we connected the Stephen Bradbury to the Sand Shifter and began the 70 nm trip to Chatham. Due to the slow speed (five knots without a head current or seas), the Sand Shifter got as far as Falmouth where she was docked for the night. On Tuesday she continued the trip and arrived in Stage Harbor late afternoon and dropped her ‘spuds’ in the harbor.
  • Our Booster Station that was down in Georgia from early August to mid-October (having the pumping part of the Booster Station rebuilt) was moved from Baxter Cranes’ yard in Yarmouth to Harding Beach in Chatham. The Booster Station will be positioned in between the dredge and the discharge area (Cockle Cove), more on this next week.
  • More pipe! An additional 3,000 feet of pipe had to be purchased to complete the total length of ~12,000 feet. Ten sections of Three-Hundred-foot lengths had to be assembled.
  • And still more pipe! We have an additional 2,500 feet that must be floated and capped and moved from Parkers River, Yarmouth to Stage Harbor to complete the length required.

To follow are some photos from some of the various stages of the mobilization as noted above.

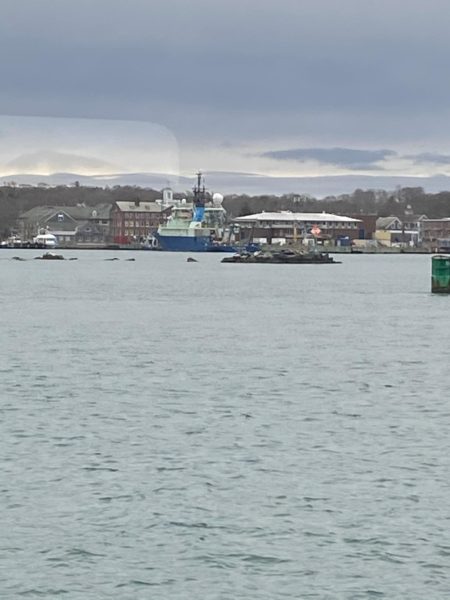

Woods Hole
Woods Hole as Sand Shifter passes by at slack tide
Chatham Harbormaster
Chatham Harbormasters rescue boat moving nav-aid out of the way so the Sand Shifter can enter the channel near low tide

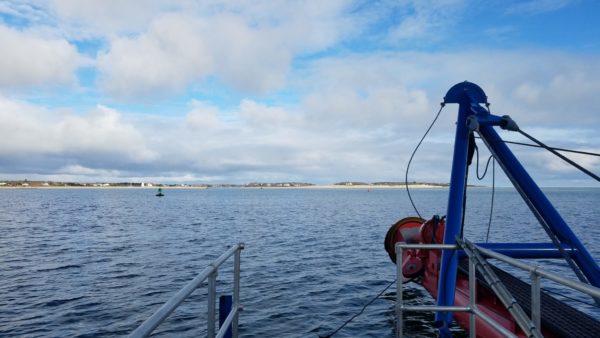

Outside Stage Harbor
Sand Shifter making the approach outside of Stage Harbor
Pushboat Stephen Bradbury
Pushboat Stephen Bradbury looking aft
Pipe arriving
Pipe under tow arriving in Stage Harbor

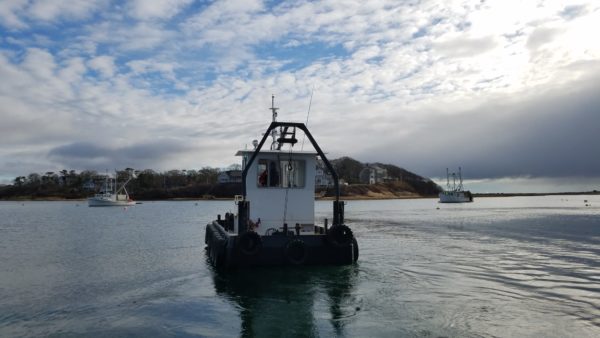

Arriving in Stage Harbor
Pushboat Stephen Bradbury arriving at harbormasters office in Stage Harbor
Pipe outside of Harding Beach
Moving the pipe south of Harding Beach in Chatham

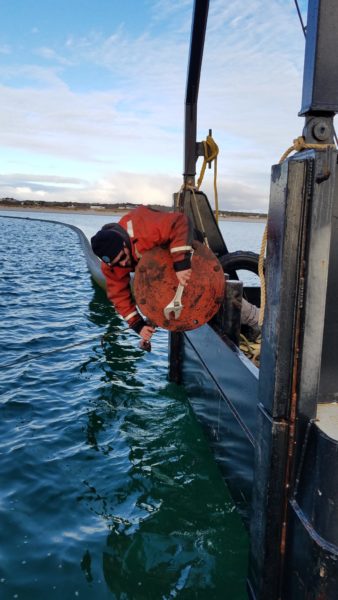

Removing plate from pipe
Rich Randall removing the plate from the pipe
Spuds
‘Spuds’ onboard the Sand Shifter
